Gabon: boulevard de la transition project faces financial scrutiny

Economie

Gabon: boulevard de la transition project faces financial scrutiny

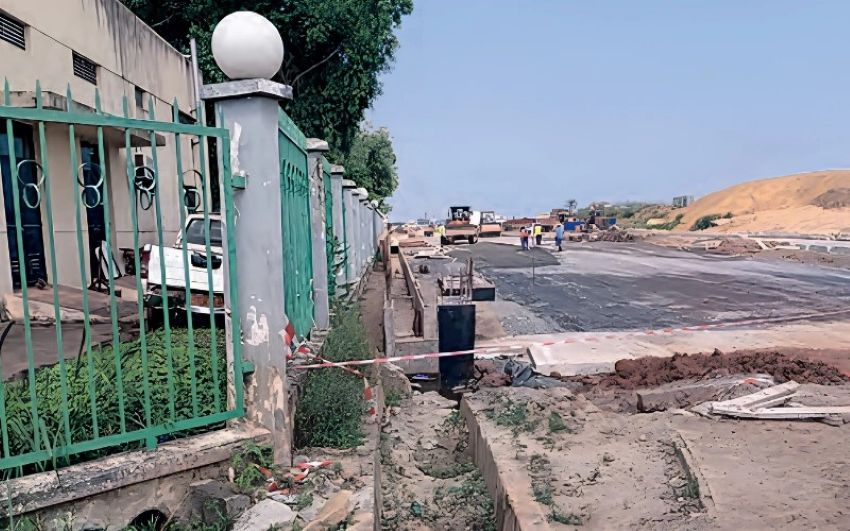

Libreville, Wednesday, August 26, 2026 – The Boulevard de la Transition project in Libreville is currently progressing on two distinct fronts. On the ground, construction teams are under pressure to accelerate work, aiming to overcome delays and deliver the initial sections of the road. Simultaneously, within government offices, a more delicate endeavor has commenced: meticulously tracking the utilization of public funds allocated to this significant infrastructure.

An investigation, whose findings emerged on August 23, revealed a substantial increase in the project’s financial scope. The initial contract amount of 8 billion CFA francs reportedly escalated to 16 billion CFA francs. Furthermore, approximately 3 billion CFA francs were allegedly disbursed to a foreign operator identified as Goran. These revelations, which require formal corroboration by judicial authorities, have cast a shadow of doubt over this flagship construction project, raising serious questions about the management of public procurement.

The sensitivity surrounding this matter is heightened by the fact that the Boulevard de la Transition is a cornerstone of Libreville’s modernization agenda. Spanning approximately three kilometers, this vital artery is designed to alleviate traffic congestion in the capital and forms an integral part of a broader urban development plan, which includes the forthcoming Administrative City. The government had already designated this project as a top priority for 2026.

Originally conceived as a symbol of urban transformation, the project now finds itself embroiled in a more fundamental debate concerning state governance and the commitment to a new culture of financial transparency. Critical questions emerge: How could a public contract’s value double so dramatically? What specific procedures facilitated the disbursements that are now under dispute?

A financial inquiry now in the hands of the judiciary

According to information obtained from sources within the Taskforce responsible for the control, audit, and verification of state participations and debt, an estimated three billion CFA francs were reportedly paid to the operator Goran without the prerequisite banking guarantee. Subsequently, Goran was allegedly questioned at the B2 (intelligence services), where he reportedly acknowledged “serious errors” before departing Gabonese territory. The same sources indicate that the complete dossier has since been forwarded to the public prosecutor.

These serious allegations necessitate absolute caution. At this juncture, the publicly available information does not definitively establish that an infraction has occurred, nor does it assign criminal responsibility to any specific individual. It is precisely the mandate of the judicial inquiry to ascertain the nature of these financial flows, validate the contractual procedures, identify any potential responsibilities, and clarify the circumstances surrounding the operator’s departure.

Nevertheless, crucial institutional questions persist. If the absence of a prior banking guarantee is indeed confirmed, why was this essential condition not enforced before the funds were disbursed? If the project’s cost truly doubled, what contractual amendments, administrative approvals, and economic justifications account for such a significant increase?

These inquiries extend beyond the specific case of Goran. They delve into the very mechanics of public procurement, a domain where administrative decisions, private enterprises, public financing, and economic interests converge.

The urgency of paving must not overshadow financial accountability

Concurrently with the financial investigation, the Taskforce has reportedly intensified its oversight of the construction site. A report dated August 22, which I have reviewed, specifically calls for the rapid procurement of materials, an increase in logistical resources, and the resumption of night work. During a meeting on August 20, the presidential directive set a target to bring the section between PK0+240 and PK0+800 to the impregnation phase by September 1.

This accelerated work schedule aligns with the project’s urban significance. However, it also raises critical governance issues. While the state rightfully seeks to complete an infrastructure that residents eagerly anticipate, it must equally safeguard evidence, meticulously document contracts, and establish any potential liabilities when an audit uncovers irregularities.

The paradox of the Boulevard de la Transition lies precisely here. As the construction becomes more visible, the demand for transparency must escalate. The public not only expects to see progress on the asphalt; they also deserve a clear understanding of the project’s actual cost, the reasons behind that cost, and the specific rules governing the awarding and execution of its contracts.

This imperative is amplified by the government’s past experiences with the financial and social ramifications of major urban works. In 2025, the Council of Ministers notably approved a waste management plan for debris resulting from demolitions linked to Libreville’s modernization and the Boulevard de la Transition project. Furthermore, the relocation initiative for affected populations received support from the BDEAC.

Therefore, this dossier must be monitored along two parallel and inseparable tracks. The first involves the effective delivery of the infrastructure. The second concerns the financial integrity of the contract. The success of one cannot, and must not, compensate for the failure of the other.

The Boulevard de la Transition should not merely symbolize a construction site measured solely by kilometers of road built. It must also serve as an opportunity to demonstrate that public investment can be rigorously controlled from its inception to the final franc spent. Should the alleged anomalies be substantiated, accountability must be established, and any resulting damages must be redressed. Conversely, if these allegations prove unfounded, the judiciary must unequivocally state so. In either scenario, the true work of the Transition mirrors the long-standing demand of citizens: to transform public spending into an expenditure that is traceable, justifiable, and verifiable.
